Phase 1
Orland/West Otter/Salem/Helmer
- Registration open (COMPLETE)
- Make ready construction (COMPLETE)
- Mainline construction (Zone 5 Helmer – pending)
- Mainline splicing (Zone 4 Orland)
- Service wire construction

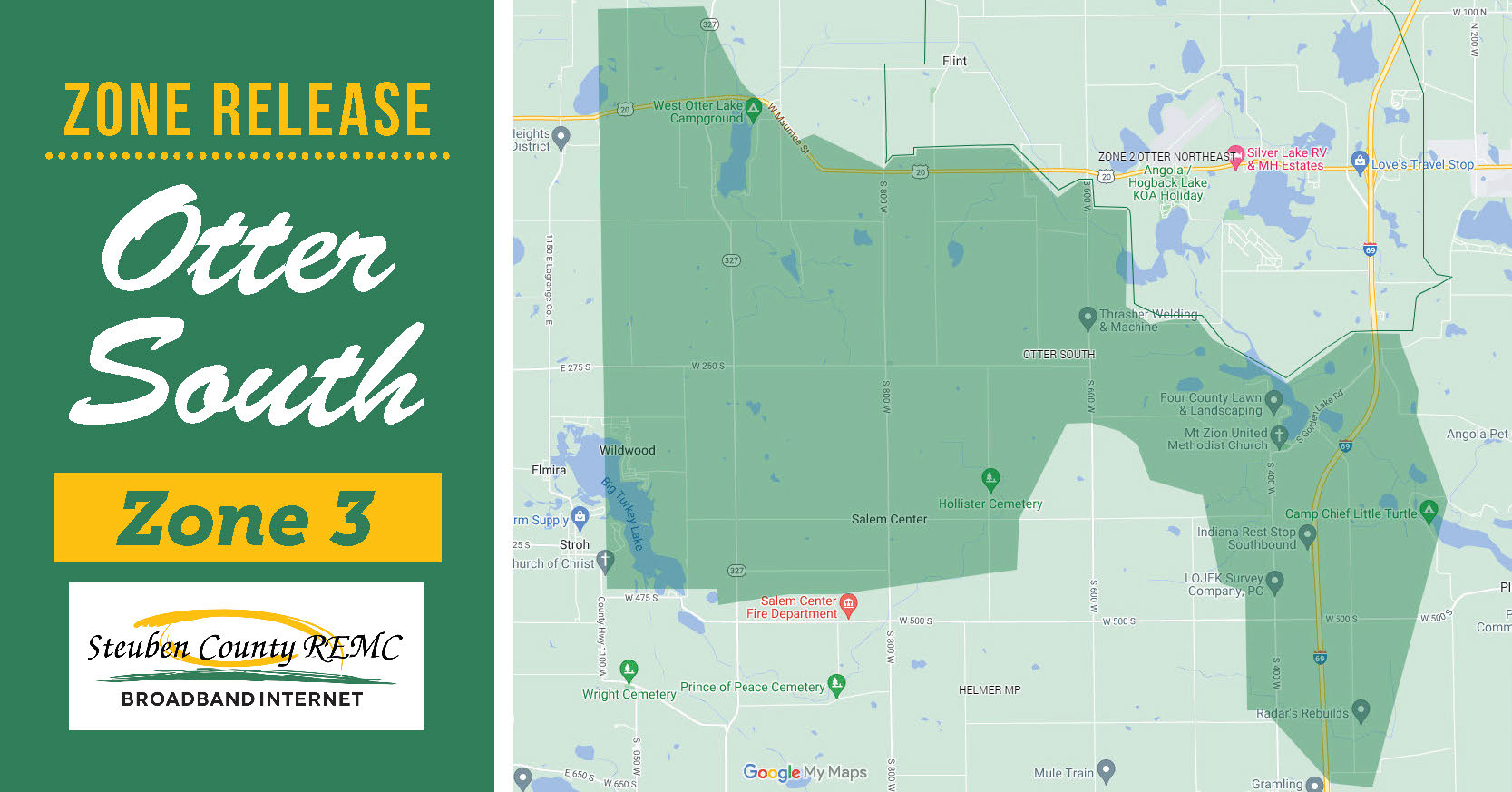

- At-home installation (Zone 1 Otter NW, Zone 2 Otter NE and Zone 3 Otter S)
Phase 2
Nevada Mills/Lake James/Crooked Lake — Construction starting after
Phase 1
- Registration open
- Make ready construction
- Mainline construction (Underground)
Phase 3
North-Central-East Angola/Fremont Construction starting after Phase 2
- Registration open
- Make ready engineering (COMPLETE)
Phase 4
South-East Angola/Ashley/Hudson Construction starting after Phase 3
- Registration open
- Make ready engineering
